THURSDAY, SEPTEMBER 04, 2025

logo

Nagaland: High Court pulls up NHIDCL, contractors over highway delays

High Court bench raps NHIDCL and contractors over highway delays in Nagaland, demands accountability and progress updates.

Published on Sep 3, 2025

By EMN

Share

logos_telegram
logos_whatsapp-icon
ant-design_message-filled
logos_facebook

DIMAPUR — The Kohima Bench of Gauhati High Court has pulled up the National Highways and Infrastructure Development Corporation Ltd (NHIDCL) and contractors engaged in major road projects in Nagaland, expressing dissatisfaction over delays, lack of progress and poor instructions provided to counsels.


A division bench of Justice Devashis Baruah and Justice Pranjal Das, while hearing two suo motu public interest litigations concerning the Kohima–Mao Gate stretch of NH-2 and the NH-29 Dimapur–Kohima four-lane project, observed that both NHIDCL and the contractors had failed to follow through on earlier commitments and appeared indifferent to the proceedings.


Nagaland: High Court pulls up NHIDCL, contractors over highway delays

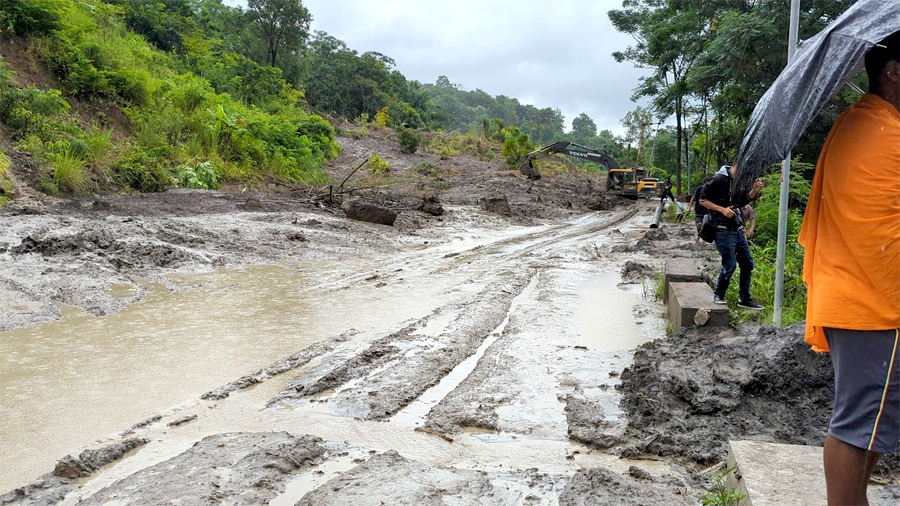

A partial view of the affected stretch along NH-29 near Dzuza Bridge in Kohima district (EM Images)


NH-2 stretch


In the matter relating to the 26.7-km Kohima–Mao Gate stretch, the court noted that despite an undertaking by contractor Vechupa Rose and Company to complete the project by May 31, 2025, only 70% of the work had been completed.


Also read: New traffic advisory after partial restoration of NH-2 near Kohima


The bench pointed out that while a 100-metre portion of the road had collapsed in a landslide in July, this did not justify delays in the larger stretch.


When asked about action against the contractor for failing to meet the undertaking, NHIDCL’s counsel had no instructions. Counsel for the contractor also admitted having no instructions on why the committed deadline was not met.


As a result, the bench observed that both NHIDCL and the contractor appeared “not serious with the present proceedings” as their counsels had been sent to court without proper instructions.


Read more: Nagaland: Landowners of 7 villages protest NH-702 realignment decision


Accordingly, the court directed competent representatives from both NHIDCL and Vechupa Rose and Company to appear before it on September 17, either in person or through video conferencing, to explain the status of the work and measures being taken for completion.


NH-29 case


In the other suo motu PIL concerning the Dimapur–Kohima four-lane road, the bench reviewed issues at the sinking zone in Chainage-164 and slope management along three packages.


Counsel for contractor Brand Eagles informed the court that a fresh work order may be required for additional components in the sinking area, though counsel for NHIDCL stated that he had no instructions on the matter. The contractor had earlier undertaken to complete Package-3 by September 2025.


Read more: Nagaland government finalises NH-702 alignment; option 3 chosen as technically superior route


The court also sought updates from Maccaferri Infrastructure Pvt. Ltd., which has been tasked with slope management and rockfall barricading in three packages. Counsel for the firm submitted that work was in full progress. Acting on a suggestion by Amicus Curiae Taka Masa, the court directed the company to file an affidavit on the progress before the next hearing.


Both contractors have been directed to submit updates, including on the issuance of additional work orders, ahead of the next hearing scheduled for September 24.
